Viewing or Converting Labour Days to Calendar Days

Post by Ken »

I have a chronogram and by default RiskyProject by default uses labour days for base duration. I would to show the calendar days. ¿How is it possible to get that?
Ken the PM
Intaver Support
Posts: 1024
Joined: Wed Nov 09, 2005 9:55 am

Re: Viewing or Converting Labour Days to Calendar Days

Post by Intaver Support »

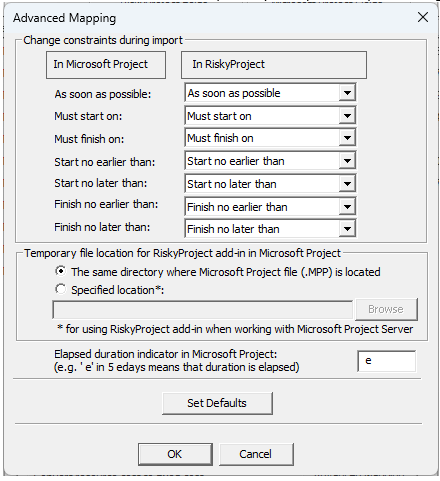

Calendar days are referred to as “elapsed days” or edays. Use of elapsed duration setting in the Advanced Settings in the desktop version when you import schedule from Microsoft Project. It is because the letter that is used to denote elapsed days is dependent upon the language settings.

http://www.intaver.com/Help4/RP_Help.ph ... pping.html

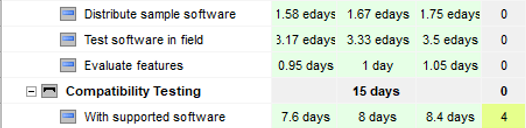

You can "switch" to elapsed days in your schedule by adding letter 'e' before time units.
