|
Event
Chain Methodology Overview |
|
Event Chain
Methodology - New Way of Project Scheduling
Intaver's
patent pending Event Chain Methodology is a new project
scheduling technique. Event chain methodology is the next
advance beyond Critical Path Method (CPM) and Critical Chain
Project Management (CCPM).
|
Event chain methodology is an
uncertainty modeling and schedule network analysis technique that is focused on identifying and managing events and event chains that affect project schedules. Event chain methodology helps to mitigate the negative impact of psychological heuristics and biases, as well as to allow for easy modeling of uncertainties in the project schedules. |
 |
Read
our articles and white papers |
Click
here to view event chain methodology demonstrations |
|
|
|
|
Event
Chain Methodology Objectives:
1. Mitigate effect motivational and cognitive biases in estimating and scheduling. In many
cases, project managers intentionally or unintentionally create project schedules that are impossible to implement. 2. Simplify the process of defining risks and uncertainties in project schedules, particularly improve the ability to provide reality checks and visualize multiple events. 3. Perform more accurate quantitative analysis while taking to an account such factors as relationship between different events and actual moment of the events.
|
|
Event
Chain Methodology Principles:
|
|

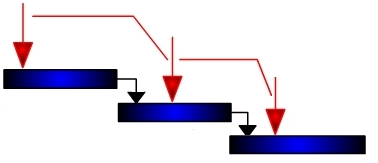

Moment of risk and state of activity
|
|
Event Chains |
|
An activity (task) in most real life processes is not a continuous uniform procedure.
Tasks are affected by external events, which transform an activity from one state to
another.
One of the important properties of an event is the moment when an event occurs during the course of an activity. This moment, when an event occurs, in most cases is probabilistic and can be defined using statistical distribution. |
Events can cause other
events, which will create
event chains. These event chains can significantly
affect the course of the project.
For example, requirement changes
can cause an activity to be delayed. To accelerate the activity, the
project manager allocates a resource is from another activity, which
then leads to a missed deadline. Eventually, this can lead to the
failure of the project.
|
|

|

|
|
Click here fore more
information |
Click here fore more
information |
|
Monte Carlo Simulations
|
|
Critical Event Chains |
|
Once events and event chains are defined,
quantitative analysis using Monte Carlo simulation can be performed
to quantify the cumulative impact of the events. Probabilities and
impacts of risks are using as in input data for Monte Carlo
simulation of the project schedule. In most real life projects, it is necessary to
supplement the information regarding the uncertainties expressed as
an event with distributions related to duration, start time, cost,
and other parameters.
|
The single events or the event chains that have
the most potential to affect the projects are the “critical
events” or “critical chains of events.” By identifying
critical events or critical chains of events, we can mitigate their
negative effects. These critical chains of events can be identified
by analyzing the correlations between main the project parameters,
such as project duration or cost, and the event chains.
|
|
|
Click here fore more
information |
Click here fore more
information |
|
History Matching and Relevance Analysis
|
|
Performance Tracking with Event Chains |
|
In many projects, it is hard to determine which
historical data should be used as an analog for future analysis. To
improve the accuracy of estimates based on risk occurrence data, the selection of analogs for the historical data
should be done through an analysis using a Bayesian approach. The
selection of an event with its respective probabilities and impact
from the historical data is based on an analysis of evidence
regarding how relevant the event is to the current activity or
project. If an event is a full or partial match according to the
selected criteria, it will contribute to the overall evidence that
this event is relevant to the current activity.
|
Monitoring the activity's progress ensures that
updated information is used to perform the analysis. During the
course of the project, the probability and time of the events can be
recalculated based on actual data. The main issue with performance
tracking is forecasting an activity’s duration and cost if an
activity is partially completed and certain events are assigned to
the activity. The simple heuristic approach to this problem is to
analyze the moment of risk, which is defined as one of the event
parameters. Advanced analysis can be performed using a Bayesian
approach.
|
|
Click here fore more
information |
Click here fore more
information |
|
Event Chain Diagrams
|
|
Repeated Activities |
|
Event
Chain Diagrams are visualizations that show the relationships
between events and tasks and how the events affect each other. The
simplest way to represent these chains is to depict them as arrows
associated with certain tasks or time intervals on the Gantt chart.
Different events and event chains can be displayed using different
colors. Events can be global (for all tasks in the project) and
local (for a particular task). By using Event Chain Diagrams to
visualize events and event chains, the modeling and analysis of
risks and uncertainties can be significantly simplified.
|
Sometimes events can cause the start of an
activity that has already been completed. This is a very common
scenario for real life projects; sometimes a previous activity must
be repeated based on the results of a succeeding activity Modeling of these scenarios using event chain methodology is simple.
The original project schedule does not need to be updated, as all
that is required is to define the event and assign it to an activity
that points to the previous activity. In addition, a limit to the
number of times an activity can be repeated needs to be defined.
|
|
|
|
|
Event Chains and Risk Mitigation
|
|
Resource Allocation Based on Events |
|
If event or event chain occurs during the course
of a project, it may require some mitigation effort. In some cases,
mitigation plans can be generated. Mitigation plans are an activity
or group of activities (small schedule) that augment the project
schedule if a certain event occurs. The solution is to
assign the mitigation plan to an event or event chain. These small
schedules will be triggered when an event chain occurs. The same
mitigation plan can be used for different events. Each mitigation
plan will have entry and exit points.
|
One potential
event is the reassignment of a resource from one activity to
another, which can occur under certain conditions. For example, if
an activity requires more resources to complete it within a fixed
period, this will trigger an event to reallocate the resource from
another activity. Reallocation of resources can also occur when
activity duration reaches a certain deadline or the cost exceeds a
certain value. Events can be used to model different situations with
resources, e.g. temporary leave, illness, vacations, etc.
|
|
|
|
|
|
|
|
|
|
