Assigning Risk Mitigation Plans
You can assign mitigation plans defined in Mitigation and
Response view to your risks. One risk may have multiple sequential
mitigation plans. They be shown as a Waterfall diagram. Waterfall
diagrams can be used to visualize the timing of mitigation efforts
over the course of the project.
- Pre-mitigation probability and
impact are results of calculation. Therefore, they cannot be
updated in the waterfall tab.
- Probability, impact, and score for the last mitigation
effort are converted into the post-mitigation probability,
impact, and score and will be shown in the Risk Register.

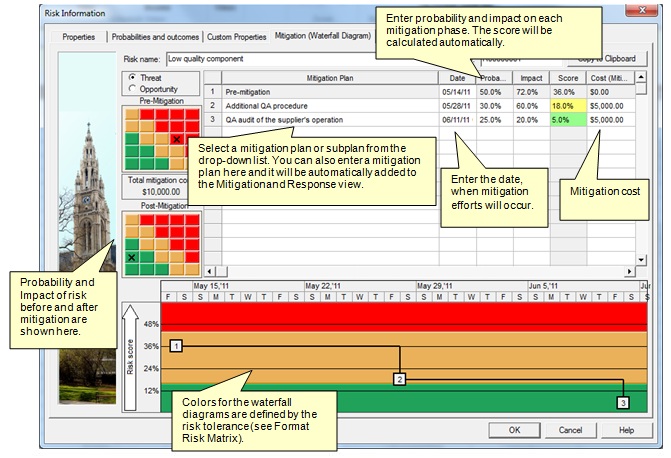

Viewing waterfall diagrams
- Open the Risk Register
view.
- Double click on Risk ID.
The Risk Information Dialog box opens.
- Click the Mitigation (Waterfall diagram) tab.
